International Finance

Cross-Border Valuation: WACC and APV

Main issues

  • Why is cross-border valuation harder than domestic?

  • Three methods for valuing foreign currency cash flows

  • Integrated vs. segmented markets: when do the methods agree?

  • WACC for international projects: logic and limitations

  • APV: the five-step framework for cross-border valuation

  • HC vs. FC valuation: the consistency check

The Investment Decision

The third firm decision

We now move from financing (Lecture 9) to the investment decision.

The question: Where should the firm invest, and what is the project worth?

This is the most complex decision — it requires everything that came before:

  • CIP and forward rates (Lecture 4)

  • Risk premia and predictability (Lecture 5)

  • Hedging rationale and exposure (Lectures 6–8)

  • Financing instruments and the basis (Lecture 9)

Why is cross-border valuation harder?

The firm value equation is the same:

\[V = \frac{E[\text{Cash Flows}]}{\text{Required Return}}\]

But both the numerator and denominator are harder:

  1. Multiple currencies — Which currency for CFs? How to convert? Need consistency.

  2. Multiple tax regimes — Tax shields depend on where you borrow and which rates apply

  3. Country risk — Adjusts CFs or DR or both? (Full treatment in a later lecture)

  4. Funding in different currencies — The basis affects debt cost (Lecture 9)

The EuroCorp example

Running example for this lecture:

EuroCorp (German industrial firm) is evaluating a US manufacturing subsidiary.

Parameter Value
Investment USD 55M \(\approx\) EUR 50M
Spot rate \(S_0\) 1.10 USD/EUR
USD risk-free rate \(r\) 4.5%
EUR risk-free rate \(r^*\) 3.0%
Forward rate (1Y, CIP) 1.1160 USD/EUR
USD unlevered cost of equity 10%
Annual USD FCF (Years 1–10) USD 9M
Debt ratio (target) 40%

Valuing Foreign Currency Cash Flows

The fundamental question

Setup: You will receive FC 1 with certainty at time \(T\).

What is its value today in home currency?

You need to move across two dimensions:

  1. Time (future \(\to\) present) — requires discounting

  2. Currency (FC \(\to\) HC) — requires conversion

The question is: in which order?

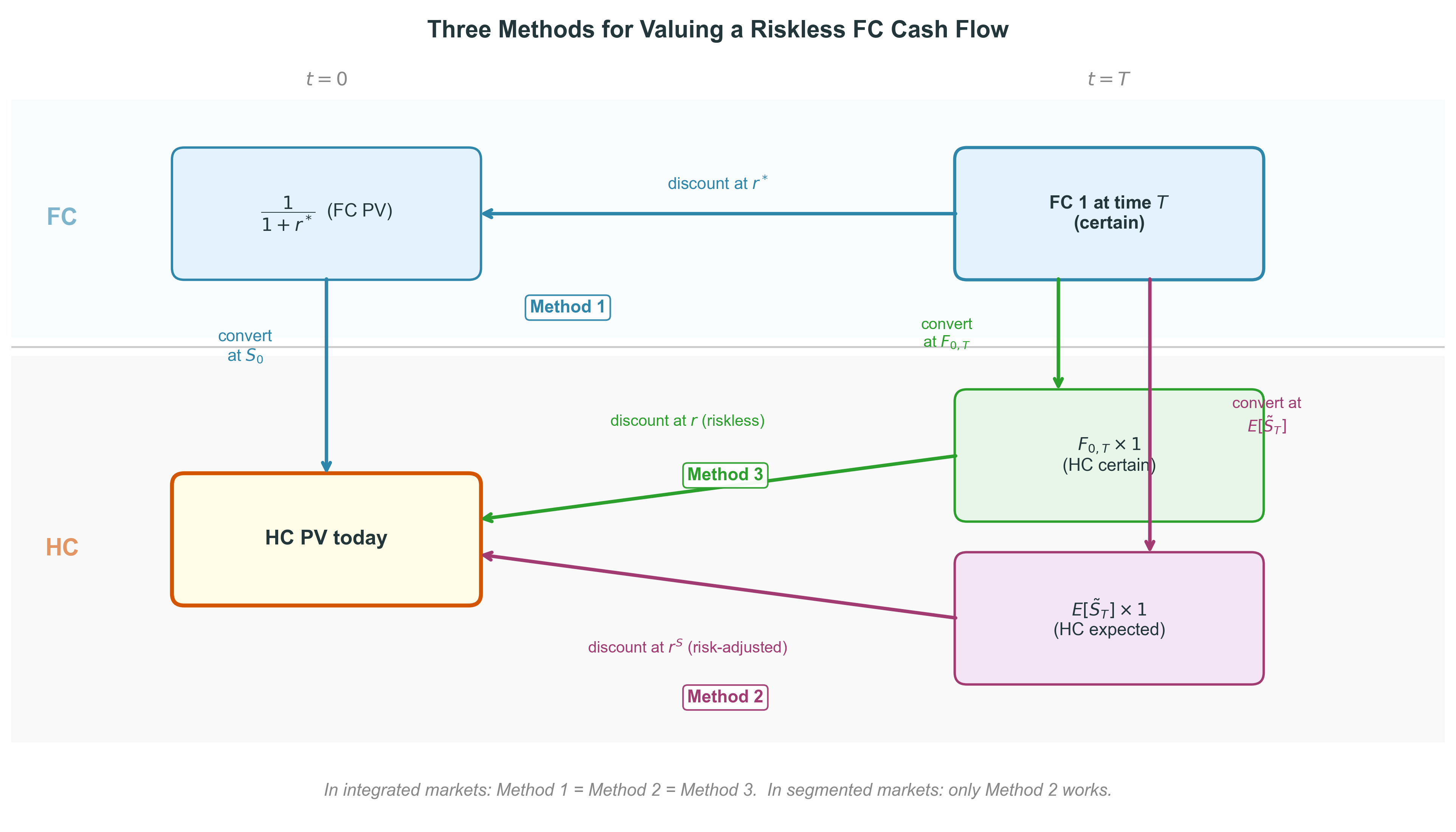

Three methods (riskless FC cash flow)

Method 1: Discount in FC, then convert

\[PV = \frac{1}{1 + r^*} \times S_0\]

  • First find the present value in FC by discounting at the FC risk-free rate

  • Then convert to HC at today’s spot rate \(S_0\)

Logic: The FC present value is known today, so converting at today’s spot is appropriate.

Method 2: Convert at expected spot, then discount

\[PV = \frac{E[{\widetilde{S}}_T] \times 1}{1 + r^S}\]

  • First estimate what the FC cash flow will be worth in HC at maturity: \(E[{\widetilde{S}}_T]\)

  • Then discount at a risk-adjusted HC rate \(r^S\) that reflects FX risk

Note: This requires an explicit exchange rate forecast — which we know is difficult (Lecture 5).

Method 3: Convert at forward rate, then discount

\[PV = \frac{F_{0,T} \times 1}{1 + r}\]

  • Use a forward contract to lock in the HC value at maturity: \(F_{0,T}\)

  • This HC value is now certain — discount at the HC risk-free rate \(r\)

Logic: The forward contract eliminates FX risk. The resulting HC cash flow is riskless, so it gets the riskless discount rate.

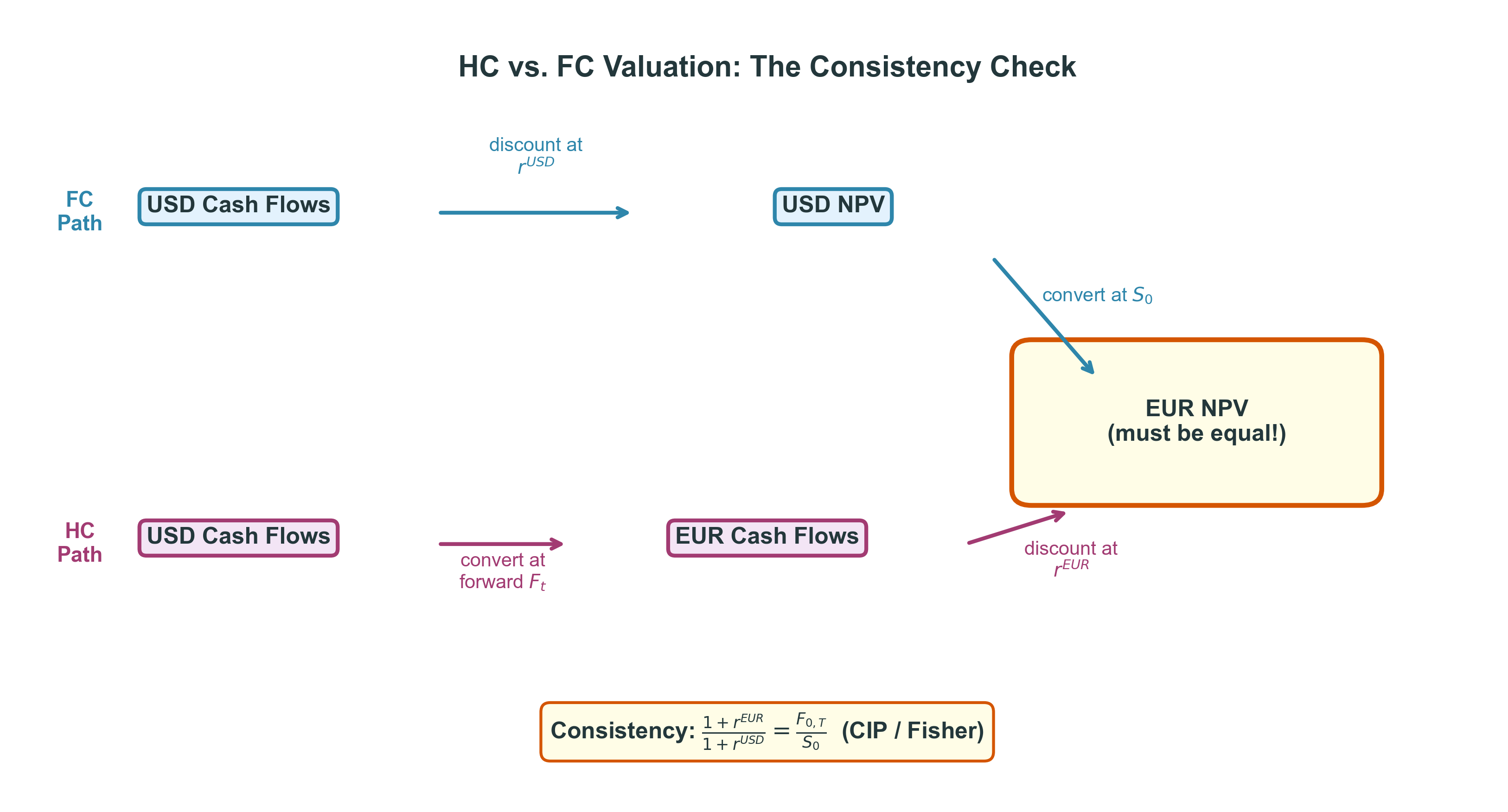

Do the three methods agree?

  • Methods 1 and 3 are always identical in integrated markets — just CIP rearranged:

\[\frac{S_0}{1 + r^*} = \frac{F_{0,T}}{1 + r} \qquad \Longleftarrow \qquad F = S_0 \times \frac{1+r}{1+r^*}\]

  • Methods 2 and 3 are identical if \(r^S\) correctly incorporates the FX risk premium

    • The forward rate is the certainty equivalent of the future spot (Lecture 4)
    • Method 2 uses the expected spot but adjusts the discount rate for FX risk — same result

\(\Rightarrow\) In integrated financial markets: Method 1 = Method 2 = Method 3

EuroCorp: riskless cash flow example

EuroCorp will receive a certain USD 5M in one year.

Method 1: Discount in USD, convert at spot

\[PV = \frac{\text{USD } 5\text{M}}{1.045} \div 1.10 = \text{EUR } 4.350\text{M}\]

Method 3: Convert at forward, discount at EUR rate

\[PV = \frac{\text{USD } 5\text{M}}{1.1160} \div 1.030 = \frac{\text{EUR } 4.480\text{M}}{1.030} = \text{EUR } 4.350\text{M} \; \checkmark\]

Both methods give EUR 4.350M. CIP guarantees this.

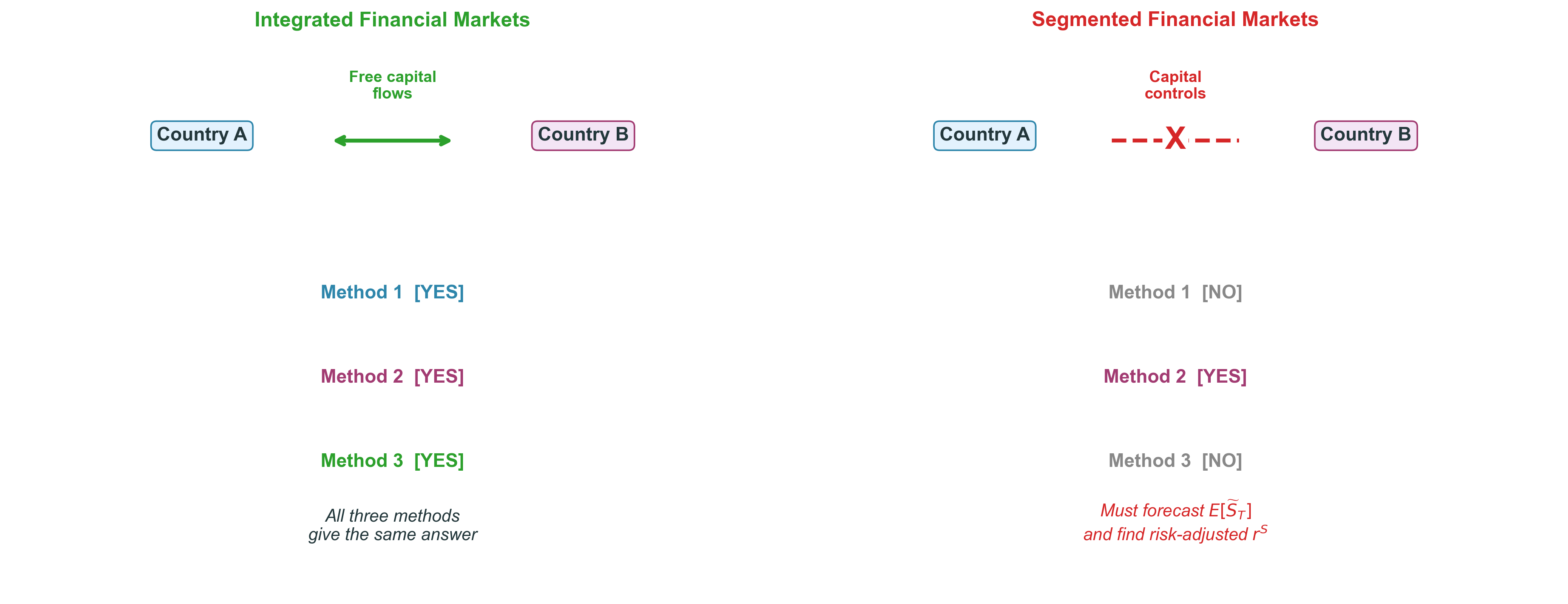

What if markets are segmented?

Segmented markets: only Method 2 works

If financial markets are segmented (capital controls, restricted forward access):

  • Method 1 fails: No mechanism equates HC value and translated FC value

    • Investors in each country may discount differently — no arbitrage links them
  • Method 3 fails: No liquid forward market; CIP doesn’t hold

    • Can’t lock in a forward rate if the market doesn’t exist
  • Only Method 2 works: Must forecast \(E[{\widetilde{S}}_T]\) and discount at \(r^S\)

This is bad news — exchange rate forecasts are unreliable (Lecture 5: random walk).

Practical rule: For EUR/USD, GBP/USD: use Method 3 (forward rates). For EM with capital controls: you may be forced into Method 2.

Risky FC cash flows

Now the FC cash flow itself is uncertain: \({\widetilde{C}}^*_T\).

Method 1 — Discount in FC, then convert:

\[PV = \frac{E[{\widetilde{C}}^*_T]}{1 + r^{C^*}} \times S_0\]

where \(r^{C^*}\) is the risk-adjusted FC discount rate for the project.

Method 2 — Convert, then discount:

\[PV = \frac{E[{\widetilde{S}}_T \cdot {\widetilde{C}}^*_T]}{1 + r^{C^*,S}}\]

where \(r^{C^*,S}\) reflects both project risk and FX risk.

The covariance complication

In Method 2, the numerator is \(E[{\widetilde{S}}_T \cdot {\widetilde{C}}^*_T]\).

In general:

\[E[{\widetilde{S}}_T \cdot {\widetilde{C}}^*_T] \neq E[{\widetilde{S}}_T] \times E[{\widetilde{C}}^*_T]\]

Unless \(\tilde{S}\) and \({\widetilde{C}}^*\) are independent.

In practice, FX and project CFs are often correlated:

  • When USD weakens (EUR strengthens), the EUR-translated value of USD revenues falls

  • Commodity exporters: FC revenues and FX move together

Implication: You cannot simply multiply an FX forecast by a CF forecast. Must account for the covariance — or use Method 1 (which avoids this issue).

Risky CFs: equivalence in integrated markets

In integrated markets, Methods 1 and 2 give the same answer — if the discount rates are consistent.

The consistency requirement:

\[r^{C^*,S} = r^{C^*} + E[\Delta S/S] + \text{covariance adjustment}\]

The HC discount rate must reflect FC project risk plus FX risk plus their interaction.

Method 3 (Quanto forwards): Exists for risky CFs too — it “locks in” an exchange rate for a risky quantity using a Quanto forward. Conceptually elegant but beyond our scope.

Practical implication: In integrated markets (US, EU, UK, Japan), use Method 1 — it’s the cleanest. Forecast CFs in the currency they’re generated in, discount at the local rate, convert at spot.

WACC for Cross-Border Projects

WACC recap

\[r_{WACC} = \frac{D}{V} \cdot r_D \cdot (1 - \tau) + \frac{E}{V} \cdot r_E\]

Simplifying assumptions:

  • Market risk of project = average market risk of the firm

  • Debt-to-equity ratio is constant

  • Corporate taxes are the only market imperfection

Levered project value:

\[V^L = \sum_{t=1}^{T} \frac{E[\text{FCF}_t]}{(1 + r_{WACC})^t}\]

Compact and familiar: one discount rate captures everything.

What changes internationally?

Cost of equity \(r_E\):

  • Which market portfolio? Domestic index or global index?
  • Does FX risk carry a separate premium? (ICAPM lecture)

Cost of debt \(r_D\):

  • Currency-specific: USD debt vs. EUR debt have different rates
  • Basis-adjusted: synthetic funding cost \(\neq\) direct cost (Lecture 9)

What changes internationally? (cont.)

Tax shield:

  • Which country’s tax rate? Parent’s or subsidiary’s?
  • For EuroCorp: Germany (\(\tau = 30\%\)) vs. the US (\(\tau = 21\%\)). Depends on where the debt sits.

Leverage ratio:

  • Measured in which currency? Market values fluctuate with FX
  • A constant D/V ratio in USD is not constant in EUR

WACC limitations for international projects

  1. Opaque: Mixes leverage, taxes, FX, and country risk into one number — can’t see where value comes from
  1. Constant leverage: Hard to maintain when FX moves change relative values of assets and debt
  1. Country risk: Where does it go? “Add 500bp to WACC” is the most common and worst practitioner approach
  1. Circularity: Need market value weights to compute WACC, but need WACC to compute market values

EuroCorp: WACC valuation

Parameters: \(r_D^{USD} = 5.5\%\), \(r_E^{USD} = 12\%\), \(\tau_{US} = 21\%\), \(D/V = 40\%\)

\[r_{WACC} = 0.40 \times 5.5\% \times (1 - 0.21) + 0.60 \times 12\% = 8.94\%\]

USD project value:

\[V^L = \sum_{t=1}^{10} \frac{9\text{M}}{(1.0894)^t} = 9\text{M} \times \frac{1 - (1.0894)^{-10}}{0.0894} = \text{USD } 57.9\text{M}\]

NPV in USD: \(57.9 - 55.0 = \text{USD } 2.9\text{M}\)

NPV in EUR: \(2.9 / 1.10 = \text{EUR } 2.7\text{M}\)

The project creates value. But where does the value come from? WACC doesn’t tell us.

APV for International Projects

APV: the logic

Start from the same place as Lecture 6 (hedging) and Lecture 9 (financing): Modigliani-Miller.

In a frictionless world: \(V^L = V^{UL}\) (capital structure irrelevant)

With frictions (taxes, subsidies, country risk):

\[V^{APV} = V^{UL} + PV(\text{financing side effects}) + \text{country risk adjustment}\]

Key advantage: Each component is separately identified, discounted at its own appropriate rate, and transparent about where value comes from.

WACC vs. APV: opacity vs. transparency

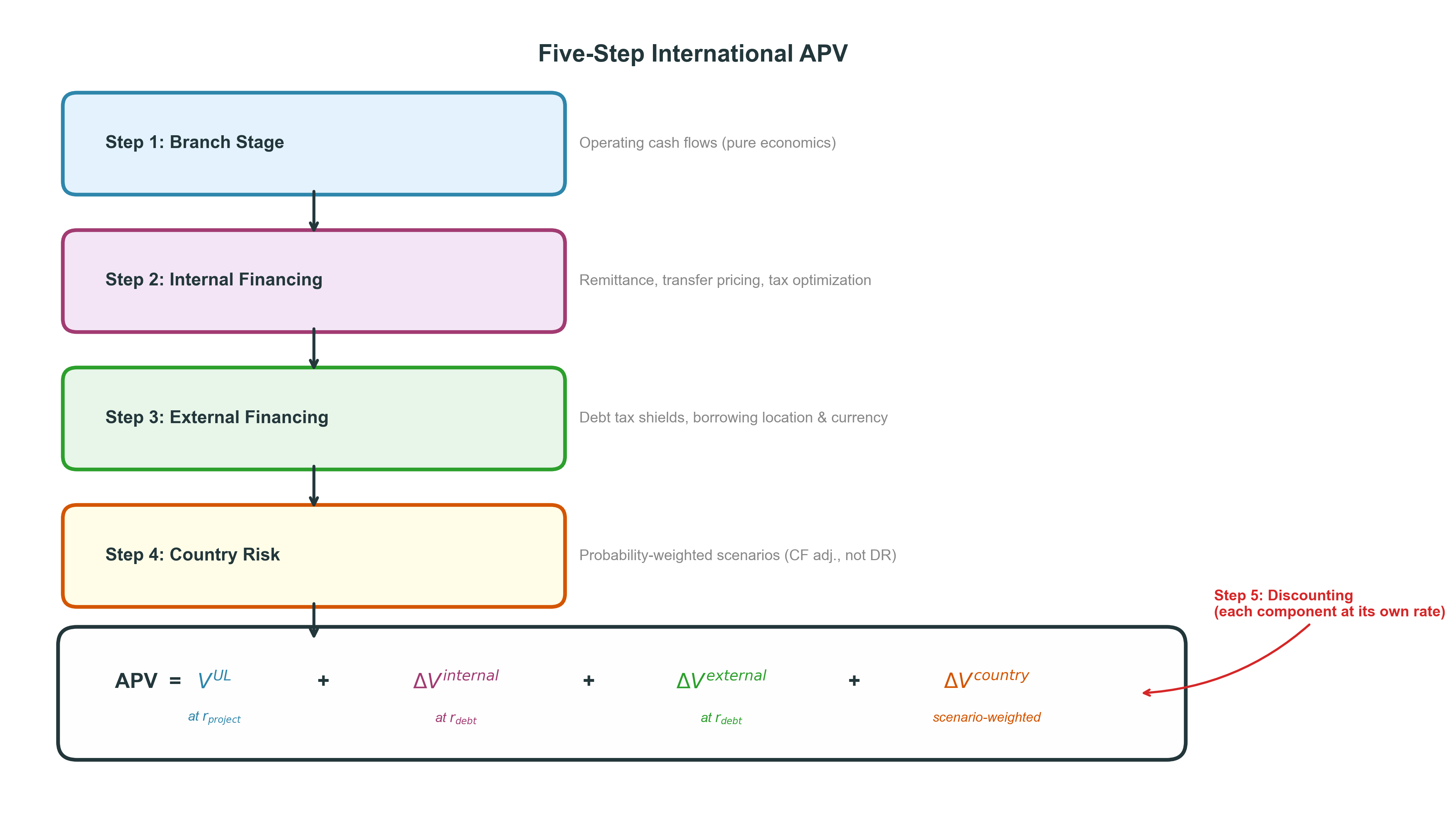

The five-step international APV

Step 1: Branch stage — operating cash flows

Treat the foreign subsidiary as an unincorporated branch of the parent.

  • Focus on pure economics: revenues, costs, capex, working capital

  • Ignore all financial arrangements (no debt, no intercompany transfers)

  • This is the project’s value on its own merits

Discount rate: Unlevered cost of equity (project’s systematic risk only).

\[V^{UL} = \sum_{t=1}^{T} \frac{E[\text{FCF}_t]}{(1 + r_{project})^t}\]

Open question: What is \(r_{project}\)? This is answered by the ICAPM (next lecture).

Step 2: Internal financing adjustments

Now the subsidiary is a separate legal entity.

Analyze intra-company financial arrangements:

  • Dividend policy: When and how much does the subsidiary remit?

  • Royalties and management fees: Payments for IP or services

  • Transfer pricing: Prices on intra-firm goods/services

  • Intercompany loans: Parent lending to subsidiary (or vice versa)

These affect taxes, FX exposure, and political risk.

Practical caveat: Tax planning is complex, evolving, and risky. Safer to accept projects primarily on their economic merits (Step 1).

Discount rate: Appropriate rate for each flow (often close to risk-free if contractual).

Step 3: External financing adjustments

The value created (or destroyed) by the firm’s financing choices:

  • Tax shields from debt: PV of interest tax deductions
    • Who borrows? Parent (Germany) or subsidiary (US)?
    • Tax shield = \(\tau \times r_D \times D\) per year (if debt is constant)
  • Where to borrow, in what currency? Connects to Lecture 9
    • Basis-adjusted funding cost; natural hedging benefits
  • Subsidized financing: Export credit agencies, development bank loans

Discount rate: Cost of debt (tax shields have debt-like risk).

\[PV(\text{tax shields}) = \sum_{t=1}^{T} \frac{\tau \times r_D \times D_t}{(1 + r_D)^t}\]

Step 4: Country risk adjustments

Preview only — full treatment in the Country Risk lecture.

Key principle: Adjust cash flows, not the discount rate.

  • Enumerate scenarios (base case, tariff, sanctions, expropriation)
  • Assign probabilities to each scenario
  • Expected CF = probability-weighted average

More transparent than “add 500bp to WACC” because:

  • Each scenario is explicit and auditable
  • Idiosyncratic risks go into CFs (probability haircut)
  • Only systematic risk goes into the discount rate

For EuroCorp’s US project: country risk is minimal — but would be critical for an EM project.

Step 5: Discounting

Different discount rates for different components:

Component Discount Rate Rationale
Operating CFs (Step 1) Unlevered cost of equity Project’s systematic risk
Internal financing (Step 2) Near risk-free Contractual flows
Tax shields (Step 3) Cost of debt Debt-like risk
Country risk (Step 4) Scenario-specific Depends on risk type

This is why APV is superior: each cash flow stream gets the rate that matches its risk.

WACC forces all components through a single rate — which can only be “right” for the average flow, not for any individual one.

EuroCorp: APV valuation

Step 1: Unlevered value (at \(r_{project} = 10\%\))

\[V^{UL} = \sum_{t=1}^{10} \frac{9\text{M}}{(1.10)^t} = 9\text{M} \times 6.1446 = \text{USD } 55.3\text{M}\]

Step 3: Tax shields (US debt \(\approx\) USD 22M, \(\tau = 21\%\), \(r_D = 5.5\%\))

\[\text{Annual TS} = 0.21 \times 0.055 \times 22\text{M} = \text{USD } 0.254\text{M} \quad \Rightarrow \quad PV = \text{USD } 1.91\text{M}\]

Steps 2, 4: Minimal for this US project (no complex transfer pricing; low country risk).

\[V^{APV} = 55.3 + 1.91 = \text{USD } 57.2\text{M} \qquad \text{NPV} = 57.2 - 55.0 = \text{USD } 2.2\text{M}\]

APV decomposition

APV vs. WACC: the comparison

Feature WACC APV
Simplicity One rate, one DCF Multiple components
Transparency Low — all mixed High — each part visible
Constant leverage? Required Not needed
Country risk “Add 500bp” (bad) Explicit CF adjustment (good)
Financing effects Embedded in rate Separated and valued
When to use Quick domestic check Cross-border projects

The WACC and APV give the same answer when:

  • Leverage is truly constant

  • No country risk to adjust

  • Project risk = firm average risk

For international projects, these rarely all hold. Use APV.

HC vs. FC Valuation: The Consistency Check

Two equivalent DCF approaches

You can value EuroCorp’s US project in either currency:

FC approach (USD):

  • Forecast CFs in USD

  • Discount at USD rate (\(r^{USD}\))

  • Convert result to EUR at spot \(S_0\)

HC approach (EUR):

  • Convert each USD CF to EUR using the forward rate for that year

  • Discount at EUR rate (\(r^{EUR}\))

Both must give the same EUR NPV.

The consistency condition

Why must they agree?

The consistency condition from CIP:

\[\frac{1 + r^{EUR}}{1 + r^{USD}} = \frac{F_{0,T}}{S_0}\]

For multi-year projects, this must hold at each tenor:

\[F_{0,t} = S_0 \times \left(\frac{1 + r^{EUR}}{1 + r^{USD}}\right)^t\]

If you use USD CFs with USD rates, or EUR CFs (via forwards) with EUR rates, the present values are identical.

Common errors that break consistency:

  • Using EUR discount rate on USD cash flows (mixes numeraire)

  • Using an FX forecast that is inconsistent with the interest rate differential

  • Double-counting FX risk in both CFs and discount rate

EuroCorp: consistency check

FC approach (Year 1):

\[PV_1^{USD} = \frac{9\text{M}}{1.10} = \text{USD } 8.182\text{M} \quad \Rightarrow \quad \frac{8.182}{1.10} = \text{EUR } 7.438\text{M}\]

HC approach (Year 1):

Forward rate: \(F_1 = 1.10 \times \frac{1.045}{1.030} = 1.1160\) USD/EUR

\[\text{EUR CF}_1 = \frac{9\text{M}}{1.1160} = \text{EUR } 8.065\text{M}\]

\[PV_1^{EUR} = \frac{8.065}{1.085} = \text{EUR } 7.433\text{M} \; \approx \; 7.438 \; \checkmark\]

The small difference (\(<\) EUR 0.01M) is rounding. Both approaches converge.

Practical guidance

Which approach to use?

  • FC approach (discount in USD) is usually simpler:

    • Cash flows are naturally generated in USD

    • No need to forecast exchange rates

    • Just discount at the USD project rate and convert once at spot

  • HC approach (convert via forwards) is useful when:

    • Management wants to see EUR cash flows

    • Comparing projects across multiple foreign currencies

    • Building consolidated EUR-denominated financial plans

  • Always check consistency: if the two approaches give different answers, there is an error in your assumptions.

Caveats for Cross-Border Valuation

Practical warnings

  1. Don’t use speculative currency forecasts. Use forward rates whenever possible.

    • If forwards aren’t available, check that your forecast is within the range implied by the interest rate differential.
  1. Be careful comparing multiples across countries. P/E ratios differ due to accounting standards, growth rates, and risk premia — not just “cheapness.”
  1. Market risk premium: Take the perspective of the actual shareholders who will bear the risk. If the firm’s shareholders are globally diversified, use the global market premium.
  1. Sensitivity analysis: Difficult-to-quantify aspects (country risk, regulatory change, competitive response) make cross-border valuations inherently uncertain. After finding the APV, stress-test your assumptions.

Summary and Connections

Key takeaways

  1. Three methods for valuing FC cash flows: Discount-then-convert, convert-then-discount, forward-then-discount. All equivalent in integrated markets; only Method 2 in segmented markets.

  2. WACC works but is opaque. It mixes leverage, taxes, FX, and country risk into one rate. Fine for a quick domestic check; dangerous for cross-border projects.

  3. APV is the preferred framework. Five-step approach separates operating value, internal/external financing, and country risk. Each component gets its own discount rate.

  4. Consistency check: HC and FC approaches must give the same answer. If they don’t, there’s an error.

  5. Open question: What discount rate for the base case? \(\to\) answered in the ICAPM lecture.

Connections to the course

  • Lecture 4 (CIP): CIP guarantees Methods 1 and 3 are equivalent. Without CIP, Method 3 fails.

  • Lecture 5 (UIP/Predictability): Exchange rate forecasts are unreliable — use forward rates, not speculative forecasts (Method 3 over Method 2 when possible).

  • Lecture 6 (Why Hedge?): MM logic underpins APV. Frictionless \(\to\) irrelevant; frictions \(\to\) APV adjustments.

  • Lecture 9 (Financing): Where and how to borrow feeds directly into APV Step 3. The basis affects the cost of financing.

  • Next lecture (ICAPM): Answers “what is \(r_{project}\)?” — the discount rate for APV Step 1.

  • Country Risk lecture: Answers “how does country risk enter?” — APV Step 4 in detail.
